Annual Road Program

Departments

The Town of Brookfield maintains a 5-year Road Program to guide decisions related to local transportation infrastructure improvements. Each year, the Town budgets for and performs routine road maintenance, such as crack sealing or pothole repairs, and road resurfacing and reconstruction projects.

Davidson Road Reconstruction

IMPORTANT UPDATES

  • This project has been rescheduled to 2027. Please see the Project Timeline section below.
  • The City of Waukesha is reconstructing their portion of Davidson Road in 2026. For more information on the project, please visit the City’s Project Webpage.

Project Overview

The Town has partnered with the City of Brookfield and the City of Waukesha to reconstruct Davidson Road from Stonehedge Drive in the City of Brookfield to the western termini in the City of Waukesha. The project includes a combination of asphalt milling and overlay, asphalt pulverizing, reshaping, and overlay and full reconstruction. In addition to the road work, a new multi-use path and curb and gutter will be installed on the south side Davidson Road to provide a safe pedestrian connection between Springdale Road and Barker Road (CTH Y). The north side of Barker Road will continue to be served by ditches and culverts. East of Barker Road (CTH Y) Davidson Road will be widened to include 4-foot paved shoulders on both sides of the road. Stormwater best management practice(s) (BMPs) will also be implemented to meet NR 151 stormwater requirements for the conversion of the rural ditch section to the urban curb and gutter roadway section. Driveway aprons will be replaced in-kind and culvert replacement will be done on an as-needed basis.

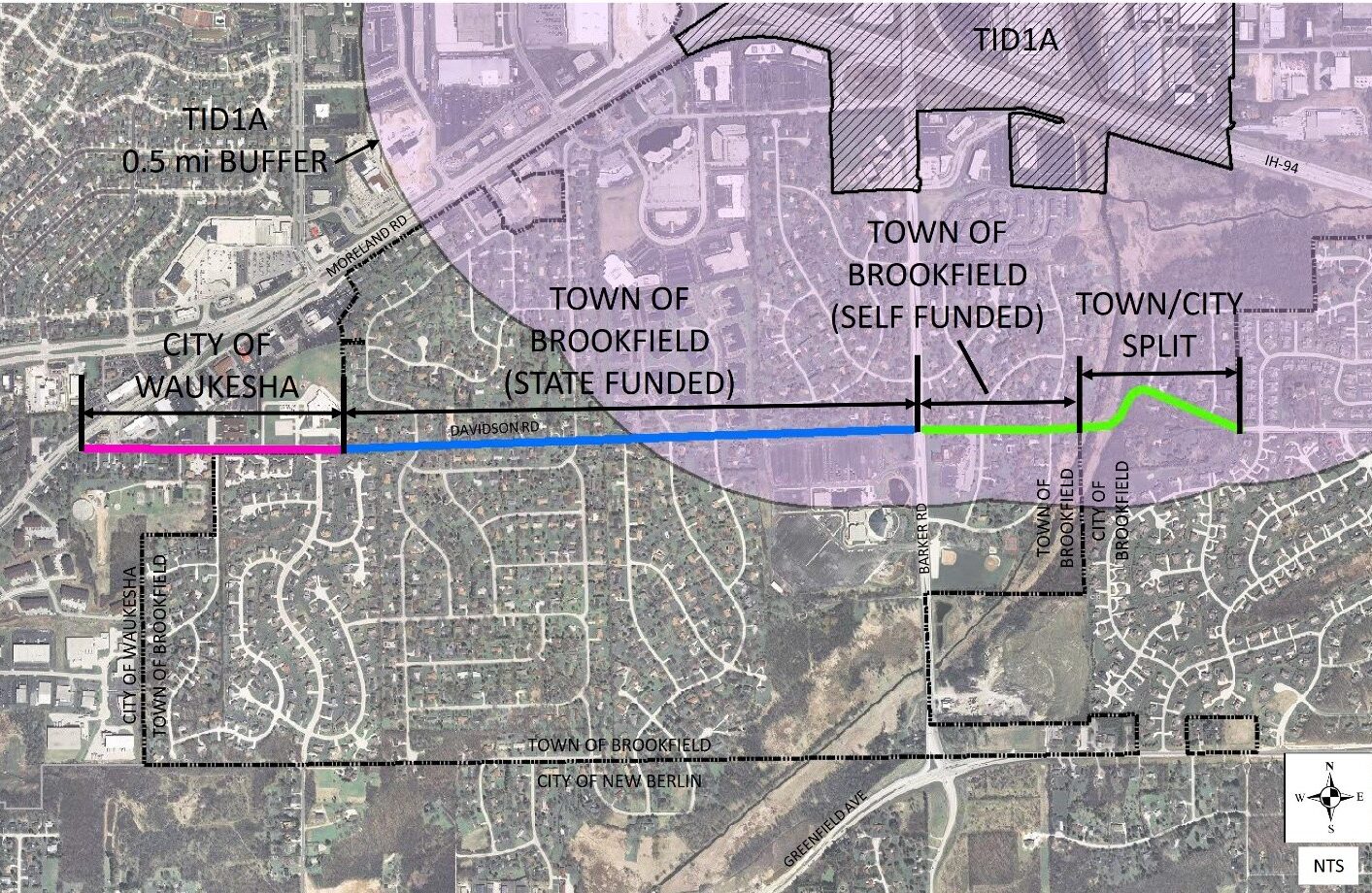

Project Overview Map

Project Funding (Town portion only)

The Town applied for and received grant funding through the Wisconsin Department of Transportation’s Local Road Improvements Program in the amount of $1.73 million. The total project cost for the Town is estimated to be approximately $3.1 million. The remaining $1.37 million will be funded through a combination of Tax Incremental District (TID) funds, stormwater utility funds, and general tax levy.

Project Timeline

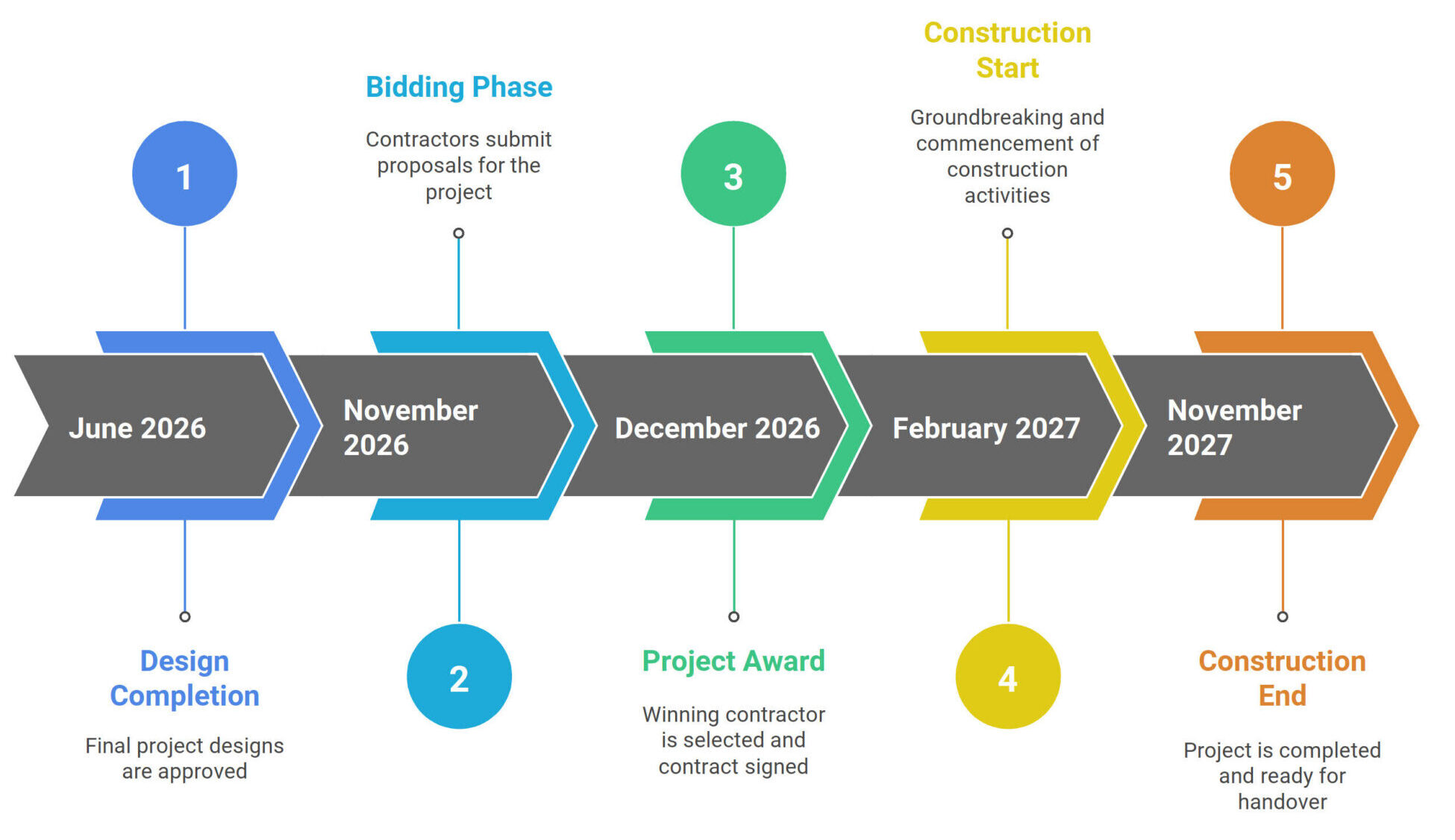

The Davidson Road Reconstruction project has been delayed until 2027 to accommodate the relocation of existing utilities. The graphic below provides an anticipated project timeline.

Additional Information

Public Information Meeting (11/19/2025) Presentation



Please feel free to call or stop by the Town Hall or call the Town Engineer, Justin Gutoski, P.E. at (608) 251-2129 ext. 1019, if you have any questions or concerns.
